Hydrotherapy / Second Journey

Recommended Launch Path

August 1 Lean

The strongest balance of scope, timing, and recovery room.

Earliest Likely First Sail

July 25

The earliest realistic in-water target in the current plan set.

Built-In Schedule Buffer

6 Days

The lean-scope options keep six recoverable dry-window days.

Project Photo Count

100 Images

Project photos currently published from the Hydrotherapy build log.

Open project photos

Launch Options

Four launch paths, shown with their real scope and real schedule risk.

The current planning package compares two target launch dates and two levels of work scope. Lean scope protects breathing room. Expanded scope uses up more of the yard window and leaves less room for surprises.

Compressed Option

July 17 launch / lean scope

Fastest workable route to the water if prep and paint stay clean.

  • Dry window: May 17 to July 16
  • Pre-launch float: 6 days
  • Earliest first sail: July 25
  • Lead time from March 23: 55 days
Full Scope

August 1 launch / expanded scope

Broader work package, but no dry-window buffer once it starts.

  • Dry window: June 1 to July 31
  • Pre-launch float: 0 days
  • Earliest first sail: August 11
  • Extra rebedding and safety checks
Stretch Schedule

July 17 launch / expanded scope

Most aggressive path: full scope, fixed date, and almost no room for surprises.

  • Dry window: May 17 to July 16
  • Pre-launch float: 0 days
  • Earliest first sail: July 27
  • Every delay pushes splash day directly

Working Schedule

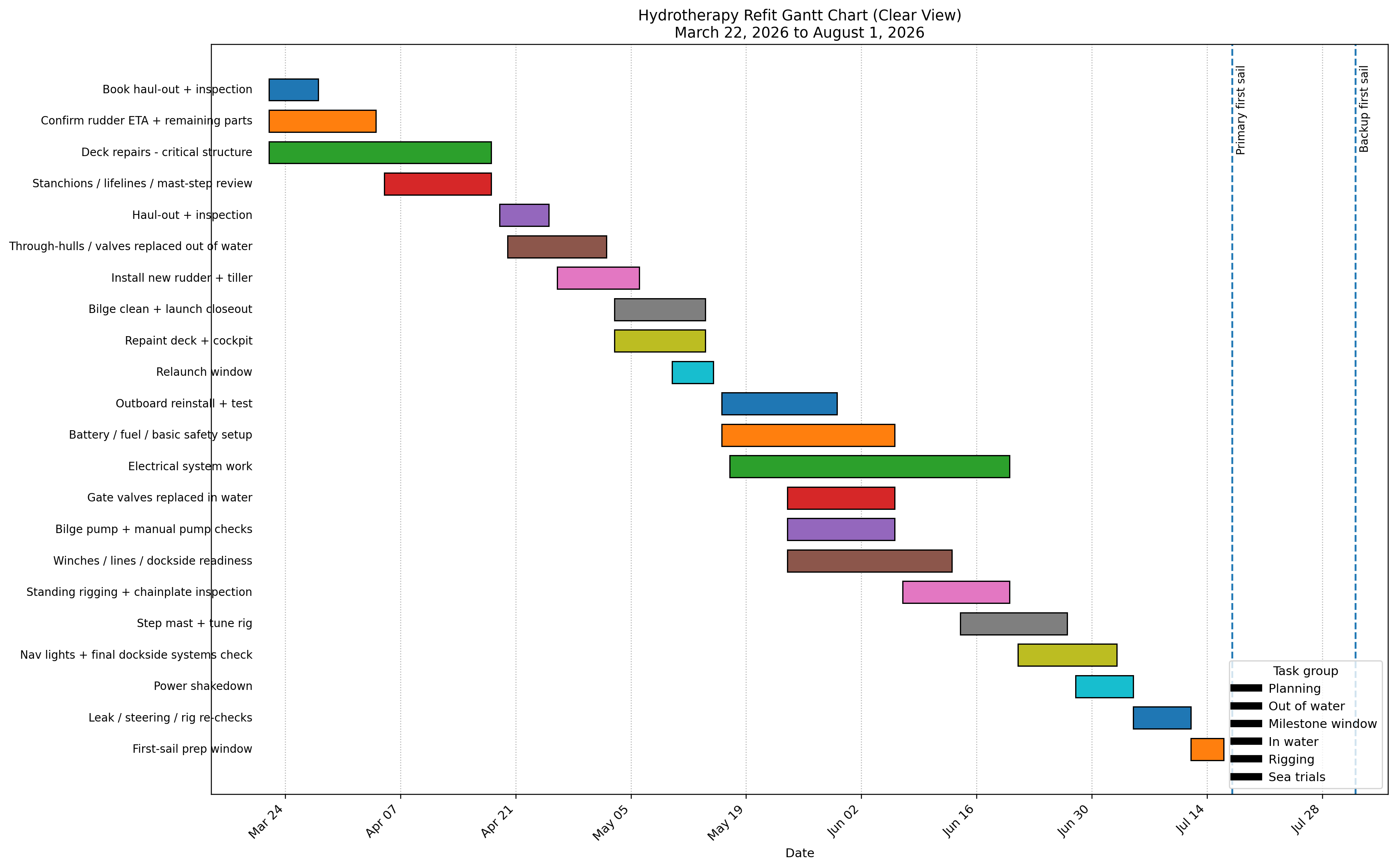

Compare the actual work sequence behind each launch option.

These schedule views show what has to happen first, what work sits on the critical path, and where each launch date is most exposed to delay.

Recommended Path

August 1 launch / lean scope

The strongest overall balance between realism, procurement time, and recoverable float before splash day.

LaunchAug 1
First sailAug 9
Dry-window float6 days
Lead time70 days

Jun 1 to Jun 6

Through valves and hose checks

Dry access starts with the must-finish systems work: through valves, hose condition, and anything hidden behind backing plates.

Jun 7 to Jun 26

Deck prep, primer, and fairing

Wash, dewax, sand, mask, then prime and touch up the surfaces that reveal themselves during prep.

Jun 27 to Jul 13

Deck and cockpit finish coats

Topcoat, nonskid, cockpit repaint, and cure time all live here. Weather is the biggest variable in this stretch.

Jul 14 to Jul 25

Rudder fit-up and launch prep

Fit the new rudder and tiller, then close out the dry-side work so launch prep is not being done in a panic.

Aug 2 to Aug 9

Commissioning and first-sail readiness

Gate valves, electrical proving, dockside checks, readiness review, then the earliest realistic first sail.

What followers should watch here

  • This path keeps six recoverable dry-window days, which is the real safety net.
  • Paint cure and weather still matter, but there is room to absorb normal interruptions.
  • Launch prep becomes the final pressure point if loose ends pile up too late.

Where The Schedule Gets Tight

Expanded scope adds more dependency chains, and that is what puts launch dates at risk.

Deck hardware removal and rebedding add a whole extra chain of must-finish work.
Fairing and spot repairs are exactly where hidden substrate surprises show up.
Expanded schedules use the full dry window, so weather and cure delays have nowhere to go.
Post-launch proving takes longer before the first confident sail.

Planning snapshot from the current Hydrotherapy schedule package.

Current Project Status

What is happening now, what comes next, and why it matters.

These updates are meant to help someone new understand the build quickly: what work is active now, what stage comes next, and what changes actually affect the launch target.

Current Work

Rotten core is being removed now, and the deck is being prepped for fiberglass repair.

The marks, cutouts, and opened sections in the progress photos show where damaged material is being taken out so the structure can be rebuilt properly before fairing, paint, and reassembly begin.

Next Phase

The next steps are more prep work, followed by fiberglass repair and rebuild.

That means cleaning back damaged areas, making sure the surfaces are ready to bond properly, and then moving into the fiberglass work that restores strength before fairing, paint, and reassembly.

Why Followers Care

The photo record is the clearest proof of both progress and schedule risk.

Some images show the goal, some show the grind, and together they explain why certain dates feel solid while others are still stretch targets.
